To record costs for a job you should first click on 'Start job costing'. Typically you will enter a
number of work dockets at a time, one after another. For that reason there are single
character keyboard shortcuts for almost all choices in this program, to avoid the delay
occasioned by switching from keyboard to mouse and back.
You first have to enter the job number and part.
· Note that we cost the different parts separately. We recommend that you enter the costs
of delivery and packing in part A.
· Also note that we need the job number, not the estimate number. If you are not using the
community edition, this is probably on your jobsheet. If you are using the community
edition, you will probably be using your own manual jobsheet, and you should make sure
that the job number, which you can find at the foot of the job desktop for any confirmed
job, is written conspicuously on it.

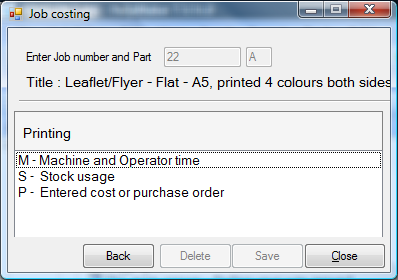

When you've selected the job and part you should see something like:
In this screen you first choose the task against which you want to record the cost, and having
chosen the task, you are offered a choice between three different cost types. You can enter:
· the time taken for a machine and operator
· stock usage, or
· an entered actual cost or purchase order.

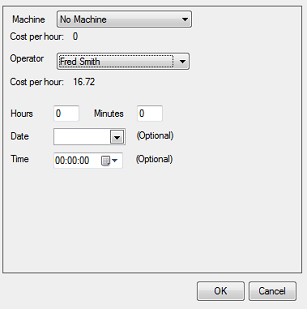

Let's deal with these in order. In the Machine and Operator time window you can select a
machine (or 'no machine') and operator, and enter how many hours and minutes this task (or
this episode of this task) took. The system should know the hourly rate for your presses, other
machines and personnel, so all you have to do is enter the time taken on this task and the
program can calculate the cost.
You should also note that if you enter the date and time, the system can construct a proper Shop Floor History record.
When you select 'Stock usage':
· if its for 'paper', you can choose the paper, weight and size used, and enter the quantity,
· if its for something else, simply select the stock category, then the item in that category,
then enter the number of units used.
In either case the system will add to the cost the proper absorption markup which is, in effect,
an allowance for that item's share of the indirect costs.

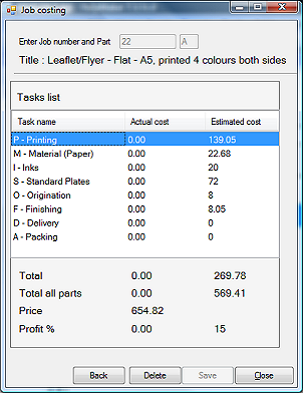

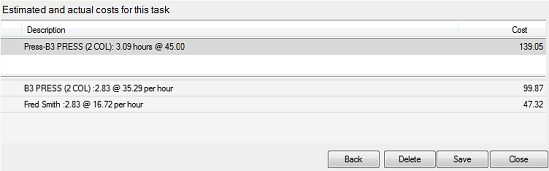

As the costs for each task are built up, you should be able to see a list at the bottom of the
window for each task, similar to the following, which enables you to see how the estimated
figures were arrived at and what 'actuals' have been entered.
The 'actuals' can also include costs entered in other ways, for instance through shop floor data
capture or via purchase invoice entry. It is possible to delete an 'actual' that has been entered
in error by pressing the Delete button. You should note that if it was entered through another
program, only the costing implications will be updated - i.e. shop floor history and purchase
invoices won't be affected.

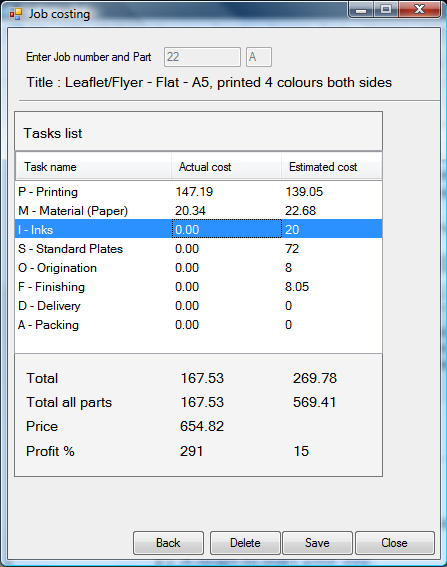

Finally we should mention the main front 'build-up' screen for job costing, in which the costs
are totalled side by side. Here you can see at the bottom the real and theoretical costs, and
profit percentage achieved.
When you have finished entering all the costs for the job you should 'sign off' the costs in the
'actions' part of the jobs desktop header tab. This means
it can then be included in profit
accrual and other programs as a fully costed job. If you think about it, there is little use
comparing estimated against actual costs until the actual costs are all entered! Even when it
is marked as fully costed you can still go on entering costs - there is often an overlooked
invoice that arrives late!
